QUEBEC CITY, Jan. 30, 2026 (GLOBE NEWSWIRE) — West African gold producer and developer Robex Resources Inc. (“Robex” or the “Company”) (TSXV:RBX, ASX: RXR, OTC:RSRBF, Börse Frankfurt: RB4)) is pleased to report on its activities for the December 2025 quarter.

Robex owns and operates the Nampala Gold Mine in Mali and continues to advance the Kiniero Gold Project in Guinea. During the quarter, the Company achieved a major milestone with the first gold pour at Kiniero, marking a significant step toward becoming a multi-asset gold producer in West Africa.

Highlights:

  • Shareholder approval secured for Robex’s proposed merger with Predictive Discovery Limited (ASX: PDI), with 94.54% of votes cast in favour at a Special Meeting. This satisfies a key condition and advances the transaction toward completion in Q1 2026.
  • First gold pour achieved at Kiniero Gold Project on 21 December 2025, placing the Company firmly on the path toward commercial production.
  • First gold milestone was delivered on time and on budget, demonstrating Robex’s strong construction, commissioning and operational capability and the performance of its world-class mine development team.
  • Kiniero poured a total of 790 ounces of gold in December
  • Processing plant ramp-up is underway, with recoveries progressing in line with expectations and nameplate capacity target in Q1 2026.
  • Kiniero SAG mill installed, key crushing circuits completed, ball mill and Phase 1B Tailings Storage Facility – planned for Q1 2026 – completed and commissioned in early January.
  • Nampala produced 11,028 ounces and sold 11,272 ounces of gold during the December 2025 quarter.
  • FY25 Gold production from Nampala totalled 45,429 ounces.
  • Production and cost guidance for 2026 calendar year will be provided later in Q2 when the Kiniero ramp up is completed.

Robex’s Managing Director and CEO Matt Wilcox commented:

The December quarter delivered several important milestones for Robex. We achieved our first gold pour at Kiniero Gold Project on time and on budget, underscoring the strength of our project execution and the capability of our team. At Nampala, consistent operational performance continues to underpin cash flow and support our regional growth strategy.

As we work towards our planned merger with Predictive Discovery, the overwhelming shareholder approval was a significant endorsement of our strategy and, upon closing of the transaction, should position the combined group to become a mid-tier gold producer in West Africa. With Kiniero progressing toward commercial production and the organisational scale that the merged entity will bring, we are well placed to deliver sustainable value for shareholders, communities and stakeholders.”

Kiniero Gold Project, Guinea

Construction Overview

Kiniero Gold Project continued to advance strongly during the December quarter, with key plant and infrastructure milestones achieved. These milestones supported the successful commissioning of the processing circuit and the achievement of first gold.

Process Plant and Infrastructure

  • SAG mill installation completed, with ball mill installation progressing and nearing mechanical completion. Mill lining remains outstanding.
  • Primary and pebble crushing circuits are mechanically complete.
  • Electrical and instrumentation works were essentially completed for first ore, with minor items remaining.
  • The processing circuit, from saprolite crushing through the SAG mill, cyclones, CIL train A and tailings, was fully commissioned, with first ore introduced on 11 December 2025.
  • Elution and gold room construction was completed and commissioned, with first gold poured on 21 December 2025.

Aerial View of the Kiniero Gold Project as at 20 January 2026

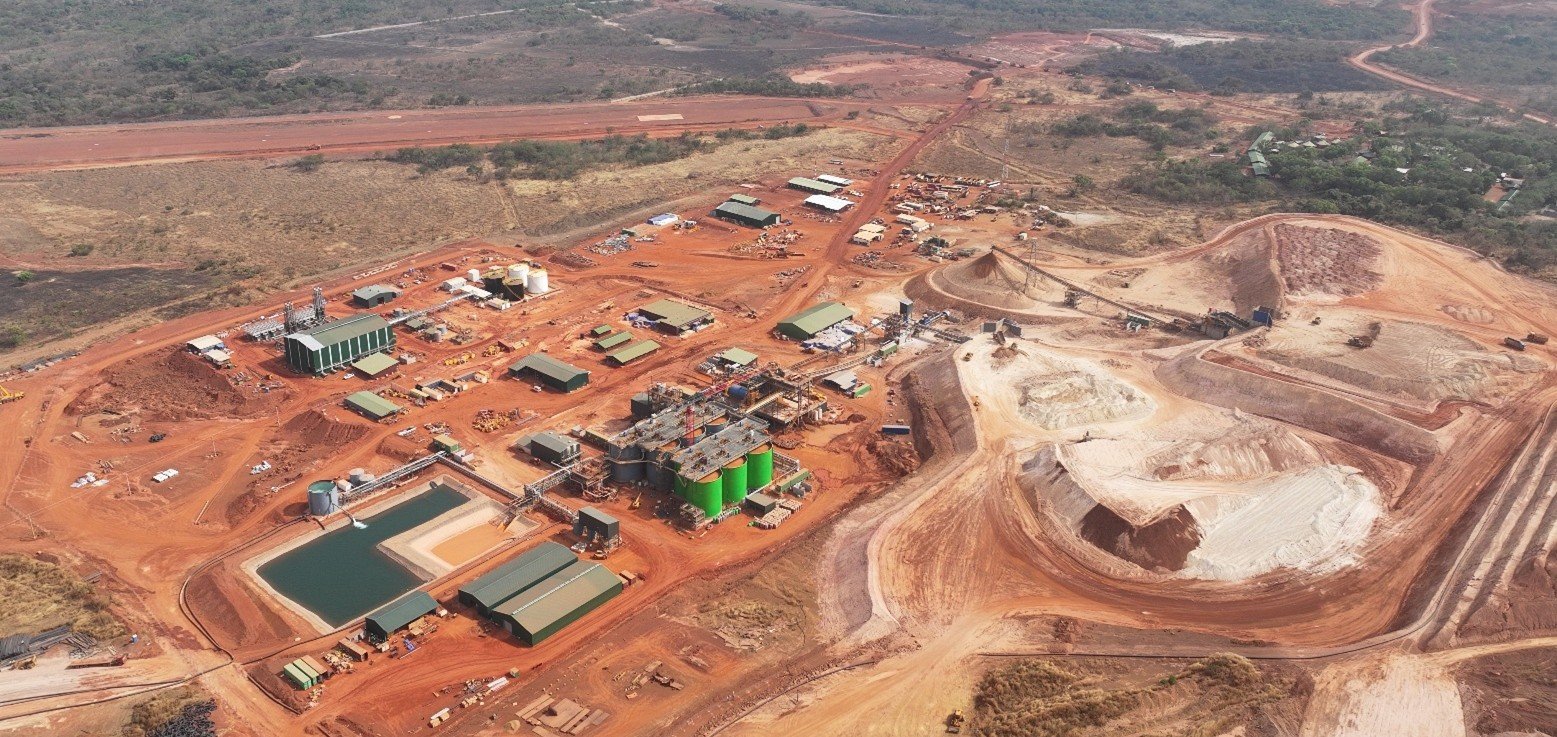

Figure 1: Aerial View of the Kiniero Gold Project as at 20 January 2026

Power Generation and Electrical Works

  • Power station advanced, with the final four engines completed, commissioned, and operated on diesel.
  • Heavy Fuel Oil (HFO) circuit progressed, with centrifuges and settling and services tanks energised and commissioning commenced.

Tailings Storage Facility (TSF)

  • Phase 1B of the Tailings Storage Facility was completed, with QA/QC documentation signed off and the facility ready to receive tailings.

Other Infrastructure

  • Minor works, including lighting installations and minor items, are being finalised to support full operational readiness.

Construction Activities – Q1 2026

Key activities originally planned for Q1 2026, now completed as of early January:

  • Ball Mill: Installation and commissioning completed
  • Processing Circuits: Primary, Pebble and CIL Train B circuits completed
  • Water Supply: Finalisation from the West Balan Pit to achieve nameplate throughput
  • Power Station: Construction and commissioning completed; all eight engines now operating on HFO
  • Tailings Storage Facility: Phase 1 completed, providing approximately two years of tailings capacity

Community Relations

During the quarter, the Kiniero Project continued to make a meaningful contribution to local communities through Robex’s Corporate Social Responsibility (CSR) program, with a strong focus on education, social initiatives, and community engagement.

  • Education initiatives were delivered to neighbouring communities, including Ballan, Kiniero, Fara-Ballan, Mansounia, and Saman, supporting the education of local children.
  • Social and cultural initiatives were undertaken ahead of the official start-up of the processing plant, fostering cultural engagement and community participation.

Environmental and Safety Performance

At the Kiniero Project, Robex maintained strong environmental, health and safety performance during the December quarter, reinforcing its commitment to responsible mining and proactive community engagement.

Key highlights included:

  • The project reached more than 6.3 million hours LTI-free since January 2024.
  • The average workforce on site increased to 1,919 personnel, reflecting the successful mobilisation of contractors of SMP, mill, electrical, power plant, and mining activities.
  • Commissioning activities progressed safely, with no incidents recorded, and all chemicals received on site were handled without issue.
  • Extensive HSE training was delivered to commissioning, processing plant and mining personnel.
  • Three community trainees joined the site, gaining hands-on experience in processing, safety, and environmental roles.
  • The on-site clinic is operational and ready to receive patients, with new medical equipment fully commissioned.
  • The environmental team was strengthened with the appointment of a new environmental supervisor, and several tonnes of waste were safely removed by an accredited contractor.
  • Tree nursery and traditional beehive programs were expanded, supporting future site rehabilitation and biodiversity initiatives.
  • The rainy season concluded in November, with favourable site conditions maintained throughout the quarter.

Kiniero Gold Project – January 2026 Progress

Primary Crusher Saprolite Crusher

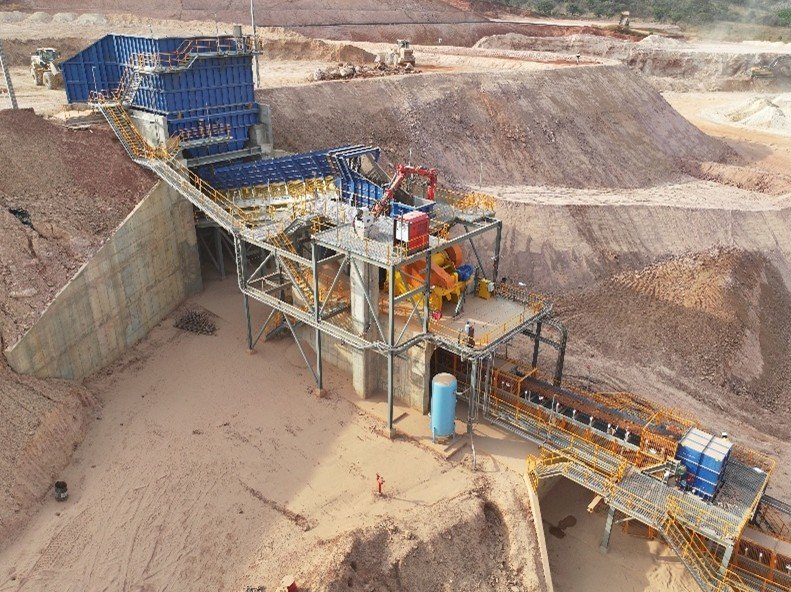

Figure 2: Primary Crusher Figure 3: Saprolite Crusher
Primary Crusher – Ore Reclaim Feed Elevation view of Processing Plant

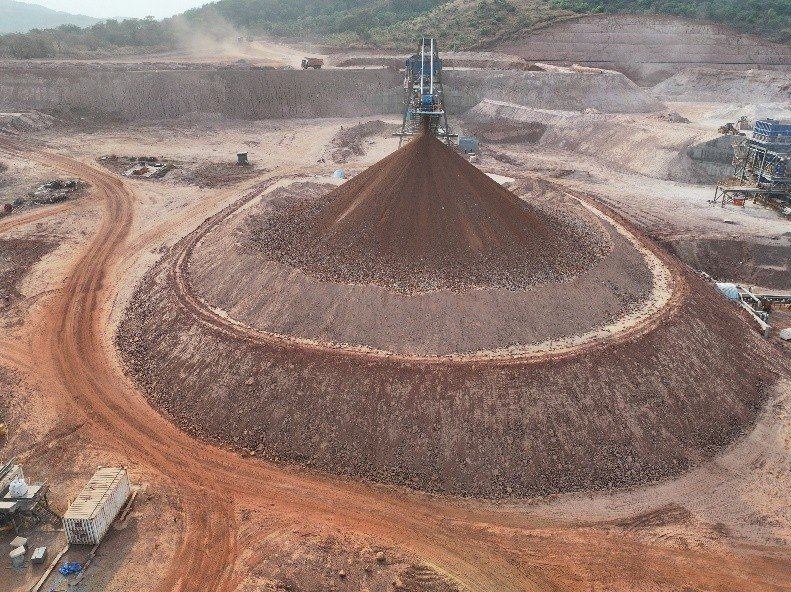

Figure 4: Primary Crusher – Ore Reclaim Feed Figure 5: Elevation view of Processing Plant
Tailings Facility Storage CIL Tank Train A & B

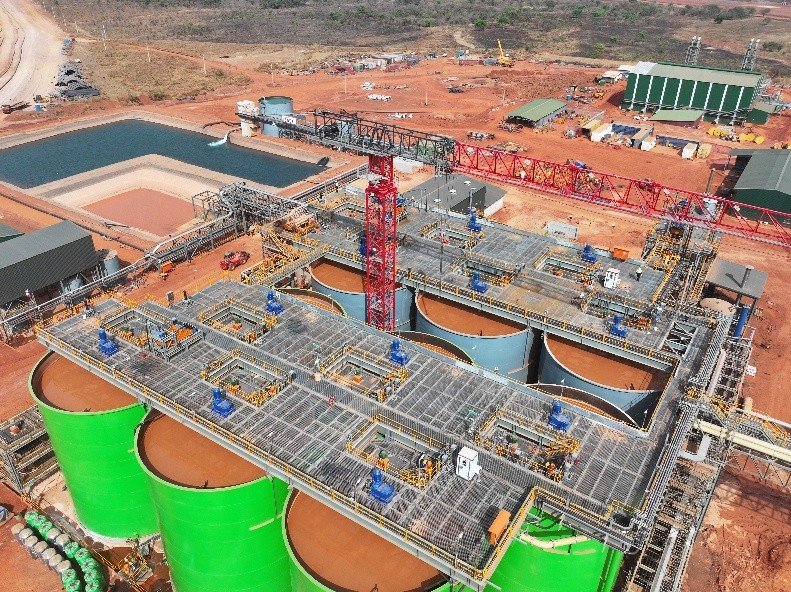

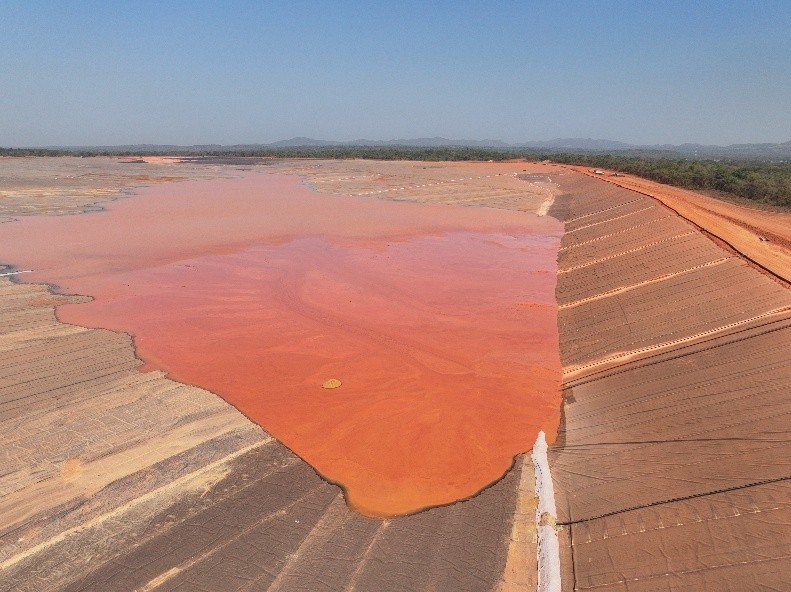

Figure 6: Tailings Facility Storage Figure 7: CIL Tank Train A & B

Nampala Gold Operation, Mali

  Units Q1 FY25 Q2 FY25 Q3 FY25 Q4 FY25   FY25
Financial Data1

Production oz 12,892 11,735 9,774 11,028   45,429
Sales oz 11,869 13,104 9,529 11,272   45,773
Average Realised Price C$/oz 4,160 4,586 4,870 5,904   4,859
Revenue C$M 49,373 60,099 46,406 66,552   222,431

Operating Data

Ore Mined t 631,515 720,924 353,818 518,297   2,224,554
Waste Mined t 2,370,569 1,964,118 1,587,604 2,016,593   7,938,884
Total Material Mined t 3,002,084 2,685,042 1,941,442 2,534,890   10,163,438
Stripping …
